The site seen from the access road: the asphalt and lane markings are in place and lighting columns have been installed along the plot. Beyond the fence, rows of rebar starters and the monolithic columns of phase one are visible.
Access road · 0:24
Frame
Monolithic column erection
A mobile crane is lifting formwork onto the next monolithic column while the crew works alongside it. The phase-one column grid is taking its design geometry; foundation cap concreting and utility installation continue in parallel.
Site footage · 0:22Site footage · 0:10
Quality control
Concrete quality control
Concrete cores have been taken for laboratory strength testing. Sample testing is a mandatory acceptance step for monolithic structures before formwork is struck and work fronts are handed over.
Foundations

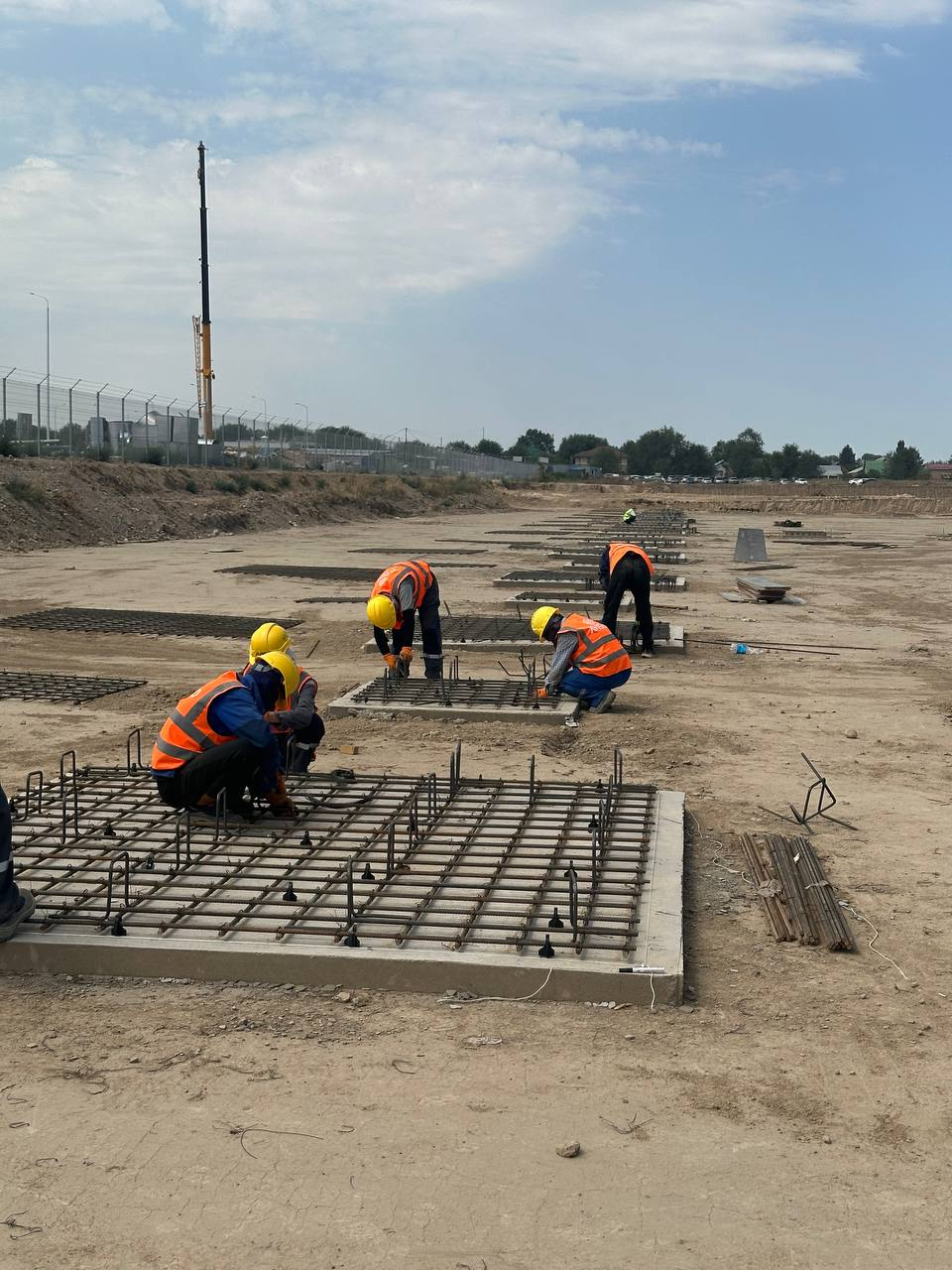

Pouring foundation caps
Freshly poured foundation cap concrete with rebar starters: once it reaches design strength, the frame columns will be installed on these supports. Work proceeds in sequential bays.
Utilities

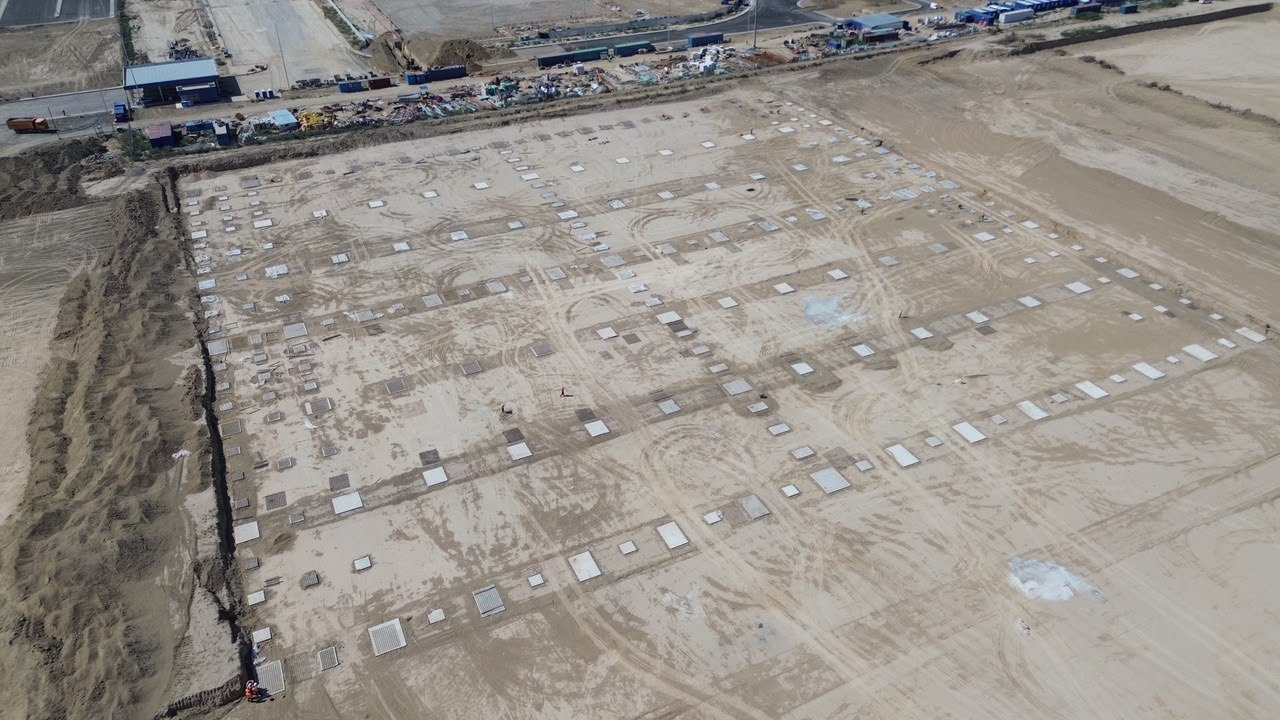

Utility networks under way
An aerial view shows the regular grid of foundation blocks with rebar starters. In parallel, a cable trench has been prepared and cable drums delivered — installation of the external power supply network is starting.
Site
The site from the air: the column grid grows
Aerial photography records the growing number of installed columns and foundations. An operating warehouse already stands next to the plot — the new complex is joining an established logistics zone beside BAKAD.
Frame
Columns and axis surveying
Some monolithic columns are already cast, others remain in formwork and rebar cages. A total station is on site to set out and check axes before the next frame elements are erected.
Foundations
Foundations and the first columns
Aerial views show the foundation cap grid and a long utility trench, alongside the first installed columns. From the ground: modular formwork, rebar cages and a mobile crane at work — the site has moved from earthworks to frame erection.
Site

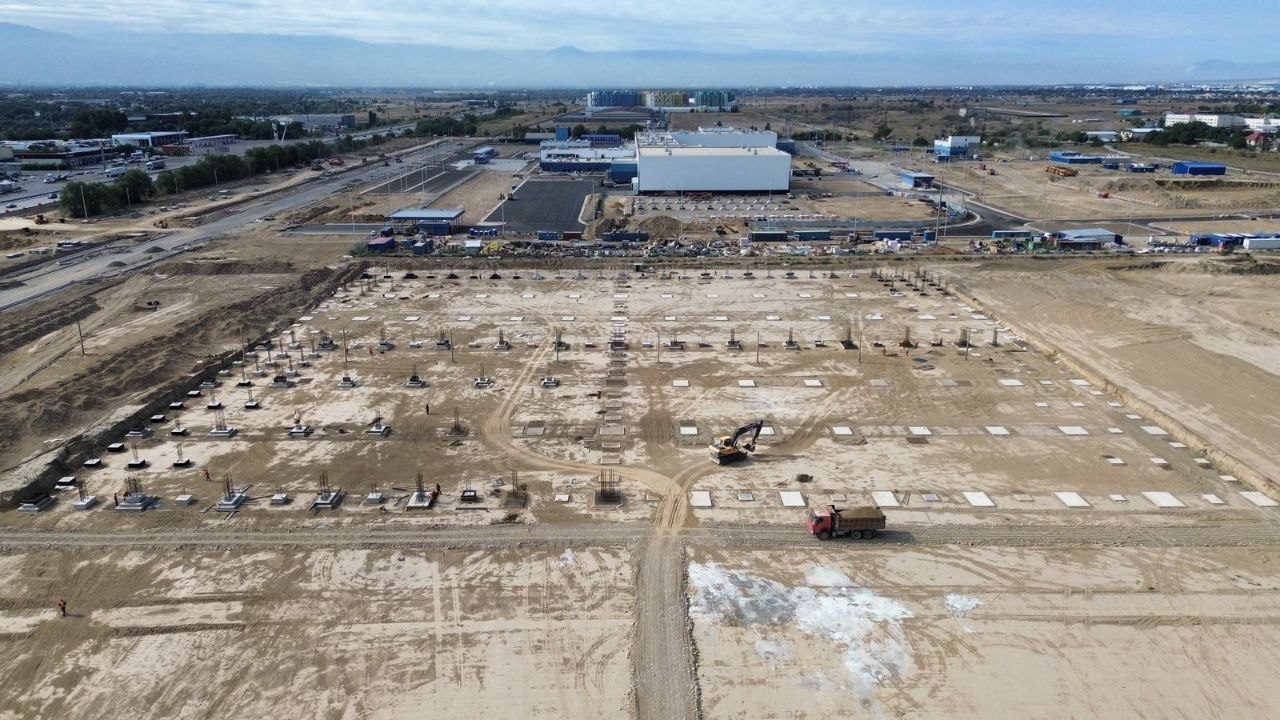

Current works status — 30 September 2026
Frame erection is under way: cranes are setting columns along the grid, and some of the columns are already concreted. Utilities are being laid in parallel, and an access road is being built along the plot.
Column installation is under way: concreting in formwork, columns in place and rebar cages. The site entrance and site compound are in place.
Site
Status as of 15 September 2026

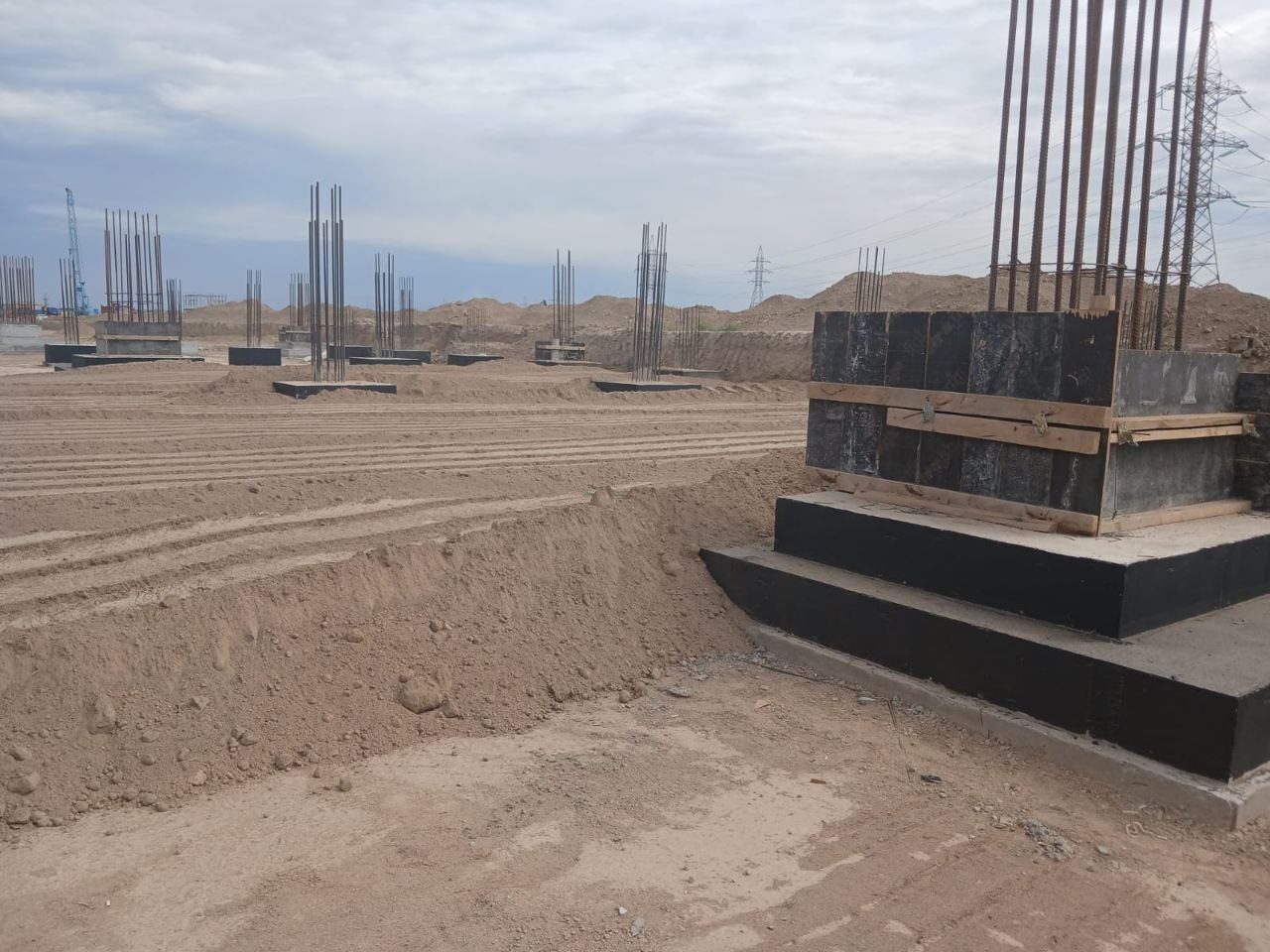

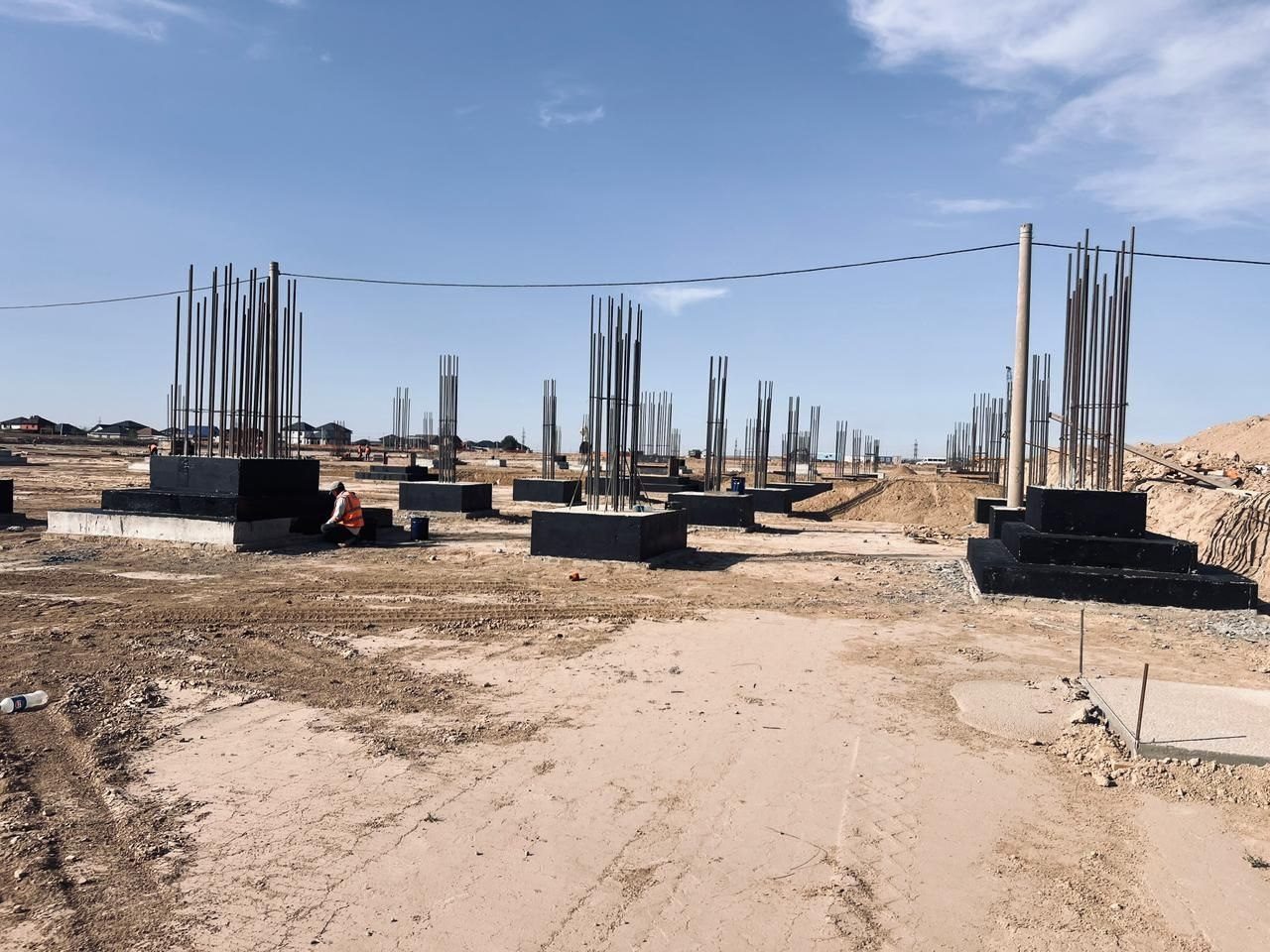

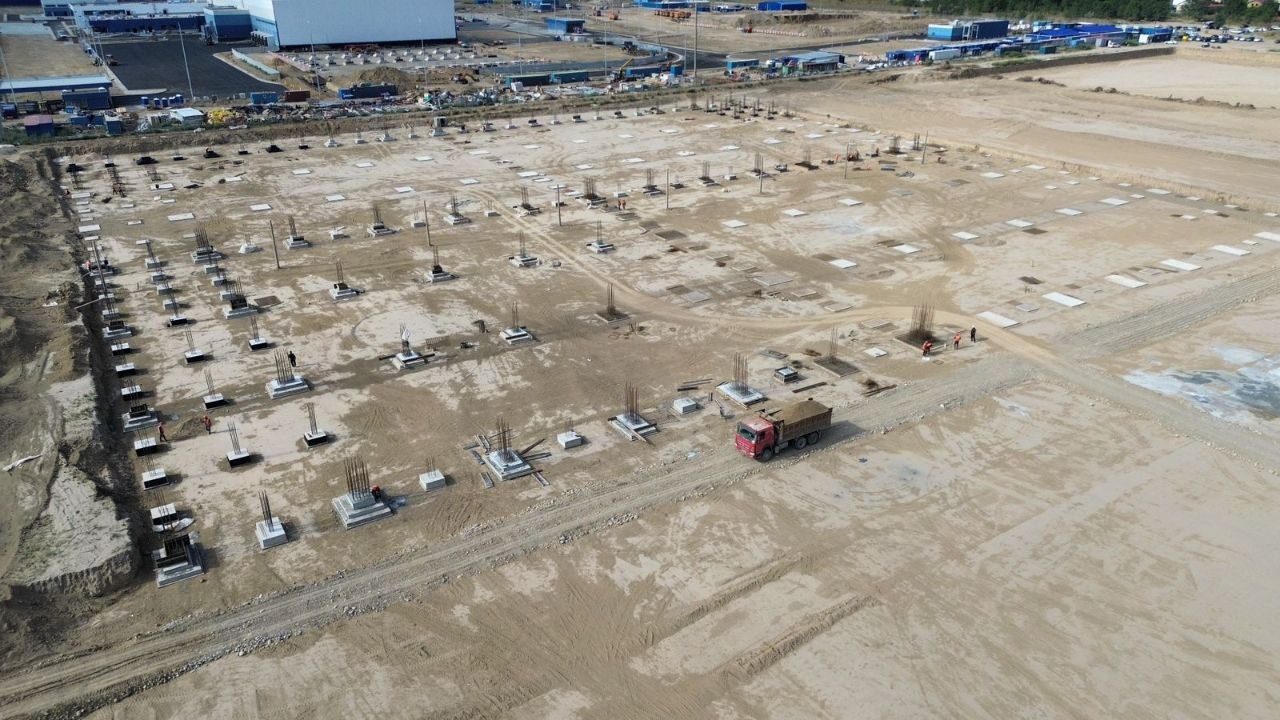

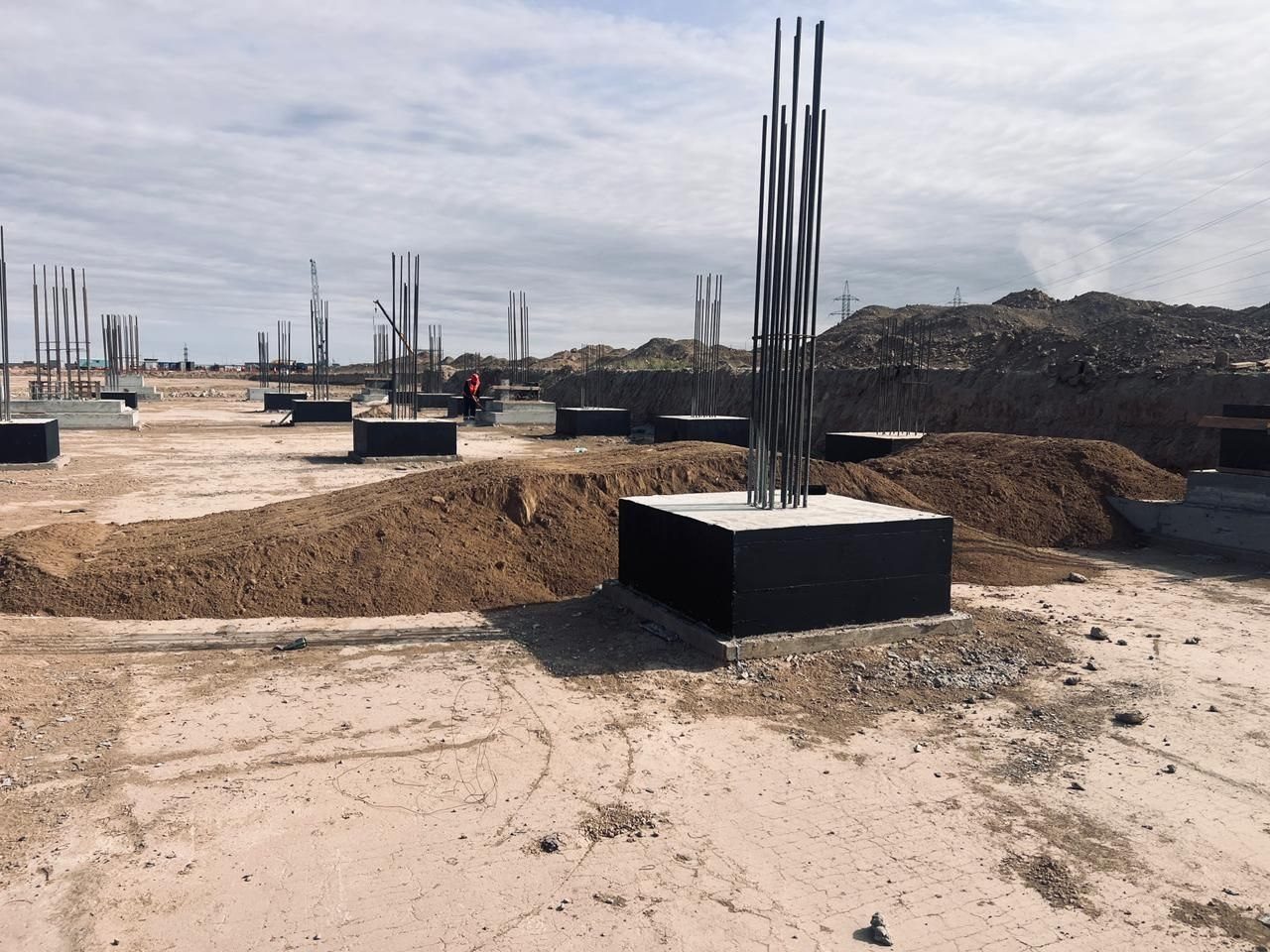

Foundation works continue: the pocket grid is complete, column rebar cages are being installed and ground-beam cages are assembled. A footpath is being laid along the access road.
Site
Status as of 18 August 2026

Earthworks, utilities installation and foundation pockets were under way on site.
